Top 5 Sewage Treatment Equipment Suppliers in Izmir: 2026 Engineering Guide with Local Compliance & Cost Data

Top 5 Sewage Treatment Equipment Suppliers in Izmir: 2026 Engineering Guide with Local Compliance & Cost Data

Izmir’s sewage treatment equipment market is fragmented, with suppliers offering capacities from 50 m³/day (municipal) to 5,000 m³/day (industrial). Local compliance requires adherence to Turkey’s Water Pollution Control Regulation (2024 update) and, for EU-funded projects, Directive 91/271/EEC. Top suppliers like EGESIS and Baysal Engineering report 92–97% COD removal for industrial wastewater (per 2023 project data), but costs vary widely: municipal package plants start at €80,000 for 100 m³/day, while industrial DAF systems average €250,000 for 500 m³/day. This guide compares 5 suppliers on specs, compliance, and ROI to help you select the right system for your project.

Why Izmir’s Sewage Treatment Market Demands Local Expertise

Izmir’s diverse industrial landscape and strict environmental regulations create unique challenges for wastewater treatment projects, necessitating a deep understanding of local conditions and supplier capabilities. Industrial zones such as Kemalpaşa and Aliağa generate high-COD wastewater, often ranging from 500–3,000 mg/L, from sectors like food processing, textiles, and petrochemicals (Bilçev, 2024 data on heterogeneous influent). This complex influent requires advanced pretreatment solutions beyond standard municipal systems.

Turkey’s Water Pollution Control Regulation, updated in 2024, mandates stricter discharge limits for total suspended solids (TSS) at less than 30 mg/L and chemical oxygen demand (COD) at less than 125 mg/L for sensitive receiving waters. This regulatory tightening has prompted an estimated 40% of Izmir’s existing municipal plants to consider upgrades to meet new compliance thresholds (Izmir Water and Sewerage Administration, 2023 report). geographic constraints impact system selection; coastal projects must account for potential saline intrusion, while inland industrial sites frequently face severe space limitations, driving a 20% year-over-year growth in demand for compact solutions like WSZ Series underground package plants in Izmir (EGESIS 2024 market report). For projects receiving European Union funding, such as the ongoing Izmir Bay Rehabilitation, compliance with EU Directive 91/271/EEC is mandatory, adding another layer of complexity that requires suppliers to demonstrate familiarity with international standards.

Top 5 Sewage Treatment Equipment Suppliers in Izmir: Technical Specs Compared

Selecting the optimal sewage treatment equipment requires a detailed comparison of technical specifications from Izmir’s leading suppliers. The following matrix provides a head-to-head analysis of key engineering parameters, drawing from supplier datasheets and 2024 project reports, to help align equipment capabilities with specific project demands.

Supplier Max Capacity (m³/day or m³/h) TSS Removal (%) COD Removal (%) Footprint Energy Use (kWh/m³) Compliance Certifications Notable Projects
EGESIS 2,000 m³/day (MBR) 99% 95% Compact (MBR) 0.8–1.2 ISO 9001, CE, Turkish Regulation Textile factory, Kemalpaşa (MBR)
Baysal Engineering 300 m³/h (DAF) 90–95% 85–92% Medium-Large (DAF) 0.3–0.5 ISO 9001, CE, EU Directive 91/271/EEC Food processing plant, Aliağa (DAF)
A.O. Smith 500 m³/day (Package Plant) 90% 85% Very Compact (Underground) 0.2–0.4 ISO 9001, CE, Turkish Regulation Yamanlar Village Recreation Area (Package)
Bilçev 1,000 m³/day (Custom) 97% (Heavy Metals) Varies by custom process Varies by custom process Varies by custom process ISO 9001, Turkish Regulation Metalworking facility, Izmir (Chemical Precipitation)
Arbiogaz 5,000 m³/day (Anaerobic) N/A (Focus on organics) 70–80% Large 0.1–0.2 (net, with biogas) ISO 9001, CE, Turkish Regulation Dairy farm, Tire (Anaerobic Digestion)

EGESIS specializes in robust industrial MBR systems, offering capacities from 10–2,000 m³/day. These systems achieve exceptional pollutant removal rates, including 99% TSS removal and 95% COD removal, making them ideal for high-strength wastewater from sectors like textiles and pharmaceuticals, though they typically exhibit higher energy consumption at 0.8–1.2 kWh/m³. Baysal Engineering is a prominent provider of DAF systems, with capacities ranging from 4–300 m³/h. Their DAF units achieve 90–95% TSS removal and 85–92% COD removal and are often compliant with EU Directive 91/271/EEC. While offering lower energy use at 0.3–0.5 kWh/m³, they generally require a larger physical footprint. A.O. Smith focuses on municipal package plants, such as their compact WSZ Series underground units, designed for 50–500 m³/day. These systems deliver 90% TSS and 85% COD removal with low energy consumption (0.2–0.4 kWh/m³), primarily for domestic wastewater applications. Bilçev provides highly customized industrial solutions, like chemical precipitation systems for metalworking wastewater, demonstrating 97% heavy metal removal, though these often entail higher capital costs, exceeding €300,000 for a 1,000 m³/day system. Arbiogaz specializes in anaerobic digestion for high-organic waste streams, such as those from food processing. Their systems achieve 70–80% COD removal and facilitate biogas recovery (0.3–0.5 m³/kg COD removed), offering a longer payback period of 5–7 years due to higher initial investment but lower operational costs over time.

Izmir’s Compliance Landscape: What Your Project Must Meet

sewage treatment equipment supplier in izmir - Izmir’s Compliance Landscape: What Your Project Must Meet
sewage treatment equipment supplier in izmir - Izmir’s Compliance Landscape: What Your Project Must Meet

Adhering to Izmir’s specific regulatory framework is paramount for any sewage treatment project, as non-compliance can lead to significant fines and operational disruptions. The primary legislative instrument is Turkey’s Water Pollution Control Regulation (2024 update), which sets stringent discharge limits: TSS must be below 30 mg/L, COD below 125 mg/L for sensitive areas (e.g., those discharging into Izmir Bay), and below 250 mg/L for less sensitive zones. Nitrogen and phosphorus limits also vary based on the receiving water body's sensitivity.

For projects receiving funding from the European Union, such as components of the Izmir Bay Rehabilitation, adherence to the EU Urban Waste Water Directive 91/271/EEC is mandatory. This directive requires secondary treatment for all urban agglomerations with a population equivalent of more than 2,000, and tertiary treatment (including nitrogen and phosphorus removal) for discharges into sensitive areas. Beyond national and EU mandates, the Izmir Water and Sewerage Administration (IZSU) imposes additional local requirements, particularly for industrial discharges, including stricter limits for heavy metals (e.g., Chromium below 0.5 mg/L) and a pH range of 6–9.

Parameter Turkish Limit (2024) EU Limit (91/271/EEC) IZSU Limit (Industrial) Typical Supplier Capability
TSS <30 mg/L <35 mg/L (90% removal) <30 mg/L 2–10 mg/L (MBR), 15–25 mg/L (DAF)
COD (Sensitive) <125 mg/L <125 mg/L (75% removal) <125 mg/L 10–30 mg/L (MBR), 30–60 mg/L (DAF)
COD (Others) <250 mg/L <125 mg/L (75% removal) <250 mg/L 10–30 mg/L (MBR), 30–60 mg/L (DAF)
Total Nitrogen Varies by zone <10-15 mg/L (sensitive) Varies by industry <5-10 mg/L (MBR with anoxic)
Total Phosphorus Varies by zone <1-2 mg/L (sensitive) Varies by industry <0.5-1 mg/L (MBR with chemical dosing)
Chromium (Cr) <1 mg/L N/A (general) <0.5 mg/L <0.1 mg/L (Chemical Precipitation)
pH 6–9 6–9 6–9 Achievable with automatic chemical dosing systems

For instance, an EGESIS MBR system deployed at a textile factory in Kemalpaşa successfully treated influent with 150 mg/L COD, achieving an effluent concentration of 7 mg/L. This performance not only met Turkish standards but also comfortably satisfied EU requirements for sensitive areas, demonstrating the system's robust compliance capability. Understanding these layered regulatory demands is crucial for accurate supplier evaluation and project planning in Izmir.

Cost Benchmarks for Sewage Treatment Equipment in Izmir: 2025 Data

Accurate cost estimation is critical for procurement teams evaluating sewage treatment equipment in Izmir, encompassing both capital expenditure (CAPEX) and operational expenditure (OPEX). The following benchmarks, derived from 2024 supplier quotes, IZSU project reports, and EU-funded project tenders, provide a realistic financial overview for various system types.

System Type Capacity Range CAPEX (€) OPEX (€/m³) Energy Use (kWh/m³) Maintenance Costs (Annual)
Municipal Package Plant 50–500 m³/day €80,000–€400,000 €0.10–€0.20 0.2–0.4 2–5% of CAPEX
Industrial DAF System 100–1,000 m³/day €150,000–€500,000 €0.25–€0.40 (incl. chemicals) 0.3–0.5 3–6% of CAPEX
MBR System 200–2,000 m³/day €300,000–€1.2M €0.30–€0.50 (incl. membrane) 0.8–1.2 4–8% of CAPEX + membrane replacement
Anaerobic Digestion 500–5,000 m³/day €500,000–€2M €0.15–€0.30 (net of biogas) 0.1–0.2 (net) 3–7% of CAPEX

Municipal package plants, such as WSZ Series underground integrated sewage treatment systems, typically range from €80,000 to €400,000 for capacities of 50–500 m³/day. Their operational costs are relatively low, averaging €0.10–€0.20/m³, with energy consumption between 0.2–0.4 kWh/m³. Industrial DAF systems, including the dissolved air flotation machine, command a CAPEX of €150,000–€500,000 for 100–1,000 m³/day. OPEX for DAF systems is higher, at €0.25–€0.40/m³, largely due to chemical costs, which can add €0.05–€0.10/m³ (HydropureWater field data, 2025), and energy use is 0.3–0.5 kWh/m³. MBR systems, like the MBR membrane bioreactor wastewater treatment system, represent a higher initial investment, ranging from €300,000–€1.2M for 200–2,000 m³/day. Their OPEX is €0.30–€0.50/m³, primarily driven by higher energy use (0.8–1.2 kWh/m³) and the need for membrane replacement every 5–7 years, which can cost €50,000–€150,000. For organic waste streams, anaerobic digestion systems, as offered by Arbiogaz, require a substantial CAPEX of €500,000–€2M for 500–5,000 m³/day. However, their OPEX is lower, at €0.15–€0.30/m³, often offset by revenue generated from biogas recovery, leading to a payback period of 5–7 years.

Beyond the direct equipment costs, project budgeting must also account for hidden costs. Permitting fees can range from €5,000–€20,000 depending on project complexity and scale. Civil works, especially for underground package plants, may add €30,000–€100,000. Finally, ensuring proper operation requires investment in operator training, typically costing €2,000–€10,000. Understanding these comprehensive cost factors is essential for calculating the true return on investment (ROI) for sewage treatment projects in Izmir.

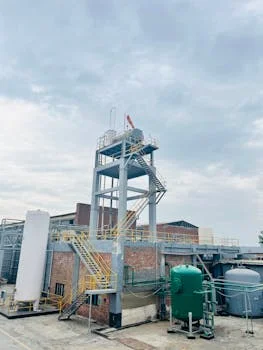

Decision Framework: Choosing the Right System for Your Project

sewage treatment equipment supplier in izmir - Decision Framework: Choosing the Right System for Your Project
sewage treatment equipment supplier in izmir - Decision Framework: Choosing the Right System for Your Project

Selecting the appropriate sewage treatment system in Izmir involves a structured decision process that aligns project requirements with equipment capabilities, budgetary constraints, and compliance mandates. The journey begins by categorizing the project type: municipal or industrial.

For municipal projects, particularly those serving small communities or recreational areas, WSZ Series underground package plants are often the most suitable choice due to their compact footprint, low energy consumption, and effective treatment of domestic wastewater. For space-constrained municipal sites requiring higher effluent quality, MBR systems offer a viable alternative. If the municipal discharge is to an existing IZSU network that requires pretreatment for specific pollutants, a DAF system might be considered.

Industrial projects demand a more tailored approach based on influent characteristics. For wastewater heavy in fats, oils, and greases (FOG) from food processing or metalworking, DAF systems are highly effective for primary treatment. Industries generating high-strength wastewater with elevated COD and TSS, such as textiles or pharmaceuticals, benefit from MBR systems due to their superior removal rates and ability to meet stringent discharge limits. For facilities with significant organic waste streams, such as food and beverage production, anaerobic digestion offers a sustainable solution, including biogas recovery.

Space constraints heavily influence system selection. Underground package plants or MBR systems, which can be 60% smaller than conventional activated sludge systems, are ideal for urban or densely populated industrial zones. Budget sensitivity is another key factor; DAF systems generally have a lower CAPEX than MBR systems but may incur higher OPEX due to ongoing chemical costs. Anaerobic digestion, while having the highest CAPEX, can offer the lowest long-term OPEX due to potential biogas revenue, albeit with a longer payback period. Finally, compliance-driven choices are non-negotiable. MBR systems are typically the most reliable for achieving EU Directive 91/271/EEC standards, especially for sensitive areas requiring tertiary treatment. DAF systems, when properly designed, can suffice for meeting Turkish Water Pollution Control Regulation limits in non-sensitive zones. Considering automatic chemical dosing systems can further optimize pH adjustment and coagulation for compliance in Izmir’s industrial projects.

Frequently Asked Questions

What are the discharge limits for sewage treatment in Izmir?

Turkey’s Water Pollution Control Regulation (2024 update) sets discharge limits for TSS at less than 30 mg/L and COD at less than 125 mg/L for sensitive areas, such as those discharging into Izmir Bay. The Izmir Water and Sewerage Administration (IZSU) may impose additional, stricter limits for specific industrial pollutants, such as Chromium below 0.5 mg/L, and a pH range of 6–9. For context, understanding how Barcelona’s industrial wastewater treatment standards compare to Izmir’s can offer a broader perspective on international norms.

How much does a sewage treatment plant cost in Izmir?

The capital expenditure (CAPEX) for sewage treatment plants in Izmir varies significantly by type and capacity. Municipal package plants start at €80,000 for 50 m³/day, while industrial DAF systems average €250,000 for 500 m³/day. MBR systems typically cost €300,000–€1.2M for capacities between 200–2,000 m³/day. Operational expenditure (OPEX) ranges from €0.10/m³ for municipal systems to €0.50/m³ for complex industrial applications, with chemical costs for DAF systems adding €0.05–€0.10/m³.

Which sewage treatment system is best for industrial wastewater in Izmir?

The best system for industrial wastewater in Izmir depends on the specific influent characteristics. DAF systems are highly effective for removing fats, oils, and greases (FOG) from sectors like food processing and metalworking. For detailed insights, refer to how DAF systems remove FOG from food processing wastewater in Izmir. MBR systems are optimal for high-strength wastewater from industries such as textiles and pharmaceuticals, providing superior effluent quality. Anaerobic digestion is ideal for processing organic waste from food and beverage industries, offering the added benefit of biogas recovery.

Do I need EU compliance for my sewage treatment project in Izmir?

EU compliance, specifically with Directive 91/271/EEC, is only required if your sewage treatment project in Izmir receives EU funding, such as for the Izmir Bay Rehabilitation initiative. This directive mandates secondary treatment for populations equivalent to over 2,000 and tertiary treatment for discharges into sensitive areas. MBR systems are generally the most reliable technology for consistently achieving EU compliance standards. For comparison, explore how Tasmania’s municipal sewage treatment plants compare to Izmir’s in terms of compliance and capacity.

What’s the energy consumption of sewage treatment equipment in Izmir?

Energy consumption varies by system type. Municipal package plants typically use 0.2–0.4 kWh/m³, while DAF systems consume 0.3–0.5 kWh/m³. MBR systems have higher energy demands, ranging from 0.8–1.2 kWh/m³, primarily due to membrane aeration and filtration. Anaerobic digestion is the most energy-efficient option, with a net consumption of 0.1–0.2 kWh/m³ when considering biogas generation, although it has a higher initial CAPEX.

Related Articles

Cincinnati Wastewater Treatment Plant Cost 2026: Engineering Specs, Local Compliance & Zero-Risk Budgeting Guide
Jun 13, 2026

Cincinnati Wastewater Treatment Plant Cost 2026: Engineering Specs, Local Compliance & Zero-Risk Budgeting Guide

Discover 2026 wastewater treatment plant costs in Cincinnati—detailed CAPEX ($1.5M–$50M), OPEX, loc…

MBR Effluent Quality for Industrial Use: 2026 Engineering Specs, Compliance Benchmarks & Zero-Risk Selection Matrix
Jun 13, 2026

MBR Effluent Quality for Industrial Use: 2026 Engineering Specs, Compliance Benchmarks & Zero-Risk Selection Matrix

Discover 2026 MBR effluent quality benchmarks for industrial wastewater: COD ≤30 mg/L, TSS ≤2 mg/L,…

Sewage Treatment Equipment Supplier in Novosibirsk: 2026 Cold-Climate Engineering Specs & Zero-Risk Selection Guide
Jun 13, 2026

Sewage Treatment Equipment Supplier in Novosibirsk: 2026 Cold-Climate Engineering Specs & Zero-Risk Selection Guide

Find the best sewage treatment equipment supplier in Novosibirsk for -40°C conditions. 2025 enginee…

AI Growth
Contact
Contact Us
Call Us
+86-181-0655-2851
Email Us Get a Quote Contact Us
