Wastewater treatment expert: +86-181-0655-2851 Get Expert Consultation
Smart Monitoring & Automation

Alarm Management SCADA Wastewater: 2026 Engineering Playbook

Alarm Management SCADA Wastewater: 2026 Engineering Playbook

Alarm Management SCADA Wastewater: 2026 Engineering Playbook

A sudden alarm flood—three critical alerts simultaneously—can plunge a wastewater plant into chaos, escalating minor process upsets into costly downtime. Effective alarm management in wastewater SCADA, guided by ISA-18.2 standards, targets fewer than 6 standing alarms per console and a nuisance alarm rate below 10%. Achieving these KPIs directly translates to a 38% reduction in unplanned downtime and an ROI payback period of under 11 months. This playbook provides the engineering toolkit to implement an ISA-18.2 compliant SCADA alarm system, complete with PLC logic, KPI formulas, and a maintenance roadmap.

Why Alarm Floods Cost More Than You Think

Unmanaged alarm systems inflate operating costs and safety risks in wastewater treatment. A typical SCADA system generating 150 alarms per 8-hour shift forces operators to spend roughly 2.6 hours of additional time each shift sifting through non-critical alerts. That overhead translates to about ¥45,000 per operator per year in China, based on average industrial technician wages. Overload diminishes operator effectiveness and delays responses to genuine critical events. One missed high-pressure alarm on a clarifier feed line can trigger a tank overflow, fines of ¥180,000 for environmental discharge violations, and up to 6 hours of unplanned downtime for cleanup and recovery. Nuisance alarms—which make up about 70% of all alarms in an unmanaged system—create a "cry wolf" effect that desensitizes operators and raises the chance a real threat gets missed. Cumulative costs of that pattern justify investment in disciplined alarm management.

Map Every Alarm to ISA-18.2 KPIs

alarm management scada wastewater - Map Every Alarm to ISA-18.2 KPIs
alarm management scada wastewater - Map Every Alarm to ISA-18.2 KPIs
ISA-18.2 KPIs give engineers a quantifiable framework for auditing and improving SCADA alarm performance. The standard sets an Annunciation Rate target of fewer than 6 alarms per hour, caps alarm floods at no more than 10 alarms within a 10-minute window, and prescribes a Priority Distribution of 5% Emergency, 15% High, and 80% Low priority alarms. These benchmarks keep the information load manageable for operators during critical events. To audit an existing system, the Average Alarm Rate is calculated as Total Alarms / Console Hours, and the Nuisance Rate as (Chattering Alarms + Fleeting Alarms + Stale Alarms) / Total Alarms. Applying these formulas isolates the specific areas where the system drifts from target, linking alarm health directly to operational efficiency.
ISA-18.2 KPI Target Value Calculation Formula Wastewater Example
Annunciation Rate < 6 alarms/hour Total Alarms / Operating Hours Average alarms per hour at main console
Alarm Flood < 10 alarms in 10 min Count instances where >10 alarms occur in 10 min Influent pump trip causing cascade of level/flow alarms
Standing Alarms < 6 active alarms Average number of unacknowledged alarms DO < 2 mg/L in aeration basin, unaddressed
Nuisance Rate < 10% (Chattering + Fleeting + Stale) / Total Alarms Influent pH > 9, fluctuating rapidly but within spec
Priority Distribution 5% Emergency / 15% High / 80% Low (Count of Priority X Alarms / Total Alarms) * 100% Sludge blanket > 2m (High), Motor temp > 60C (Medium)
Operator Response Time < 1 min (High), < 5 min (Medium) Average time from alarm annunciation to acknowledgement Response to pump overcurrent (Emergency)

Build a 4-Level Priority Matrix in Your PLC

A standardized 4-level alarm priority matrix built directly in the PLC keeps alarm behavior consistent and simplifies SCADA integration. Shifting alarm logic closer to the process improves reliability and reduces network latency. The four levels are defined by their potential impact and required operator response:
  1. Emergency: Immediate safety shutdown or catastrophic equipment failure (e.g., pump overcurrent leading to motor damage, toxic gas leak). Requires immediate operator action.
  2. High: Significant equipment damage or severe process upset within 30 minutes (e.g., high-level tank overflow, critical pump failure). Requires prompt operator action.
  3. Medium: Process upset requiring attention but not immediate danger (e.g., minor tank level deviation, routine equipment fault). Requires timely operator action.
  4. Low: Maintenance reminder or minor deviation with no immediate impact (e.g., filter runtime exceeded, non-critical sensor out of calibration). Requires deferred operator action.
Setpoint bands relative to the process trip value standardize priority assignment. Emergency alarms typically trigger within ≤5% of the trip value, High alarms between 5–15%, and Medium alarms between 15–30%. Low priority alarms sit outside these critical bands but still warrant attention. The following ladder logic snippet, compatible with RsLogix 5000 (Studio 5000 Logix Designer) environments, sets an Emergency alarm when pump current exceeds 115% of Full Load Amperage (FLA):

// Rung 0: Pump Overcurrent Emergency Alarm
// Description: Activates Emergency alarm if Pump 01 current exceeds 115% FLA

--[PUMP_01_RUN_STATUS]-----------[GRT]------------------[OTE]--
                                / Source A: PUMP_01_CURRENT_AMPS
                                / Source B: 115.0  (115% of FLA for example, assume FLA is 100A for this example)
                                / Destination: ALM_PUMP01_OVERCURRENT_EMERGENCY
`PUMP_01_RUN_STATUS` ensures the alarm is only active when the pump is commanded to run. `PUMP_01_CURRENT_AMPS` is the scaled analog input value. When current exceeds 115.0 Amps (115% of a 100 A FLA pump), the `ALM_PUMP01_OVERCURRENT_EMERGENCY` bit sets and triggers the highest priority alarm on the SCADA system. Direct PLC integration like this gives the alarm system a robust foundation. For more advanced control strategies, see our PLC automation guide.
Alarm Priority Level Definition Setpoint Band (from Trip Value) Typical Operator Response Time Wastewater Example
Emergency Immediate safety shutdown or catastrophic equipment failure ≤5% Immediate (<1 min) Pump motor overcurrent (>115% FLA), toxic gas detected
High Significant equipment damage or severe process upset (<30 min) 5–15% Prompt (<5 min) High tank level (95% full), critical pump failure
Medium Process upset requiring attention, not immediate danger 15–30% Timely (<30 min) Minor tank level deviation (80% full), motor bearing temperature high
Low Maintenance reminder, minor deviation, no immediate impact >30% or non-process conditions Deferred (>30 min or next shift) Filter press run hours exceeded, non-critical sensor calibration due

Rationalize 1000 Alarms Down to 120 Without Losing Coverage

alarm management scada wastewater - Rationalize 1000 Alarms Down to 120 Without Losing Coverage
alarm management scada wastewater - Rationalize 1000 Alarms Down to 120 Without Losing Coverage
Alarm rationalization is a workshop method that cuts alarm counts while keeping every critical process condition covered. Some plants take the count from 973 to 118 alarms in 1.5 days. The target is roughly 1 alarm per 150 control tags, focused on actionable, unique, high-impact alerts. The exercise fits inside a 2-day outage and needs input from operations, maintenance, and engineering.
  1. Step 1: Export SCADA Alarm List to CSV: Extract the complete list of current SCADA alarms into a spreadsheet. Include alarm tag, setpoint, description, potential cause, and likely consequence. This becomes the analysis baseline.
  2. Step 2: Score Severity (1-5) × Frequency (1-5): Assign a severity score (1=minor inconvenience, 5=catastrophic event) and a frequency score (1=rare, 5=constant nuisance). Multiply the scores to prioritize. Keep high-severity alarms even when frequency is low, plus the worst nuisance offenders. Retain the top 30% of alarms by score, plus anything deemed essential for safety or critical process control.
  3. Step 3: Merge Duplicate Setpoints and Consolidate Related Alarms: Eliminate redundant alarms. If a high-flow alarm and a pump run status alarm both signal an inefficient pump, merge them into a single "Pump Available" or "Pump Performance Deviation" alarm. Treat the root cause, not the symptoms.
  4. Step 4: Define Alarm Attributes: For surviving alarms, set priority (using the 4-level matrix), operator response, suggested corrective action, and suppression conditions.
  5. Step 5: Implement Changes in PLC/SCADA: Program the revised alarm logic into the PLCs and update the SCADA system so both stay aligned.
  6. Step 6: Operator Training and Review: Train operators on the new alarm philosophy and schedule regular reviews that catch any new nuisance alarms.
This structured approach keeps every alarm purposeful, improving operator awareness and reducing alarm fatigue. For more detailed guidance on process control, see our PLC automation guide.

Stop Nuisance Alarms with Deadband, Delay and State-Based Suppression

Cutting nuisance alarms rebuilds operator trust and reduces fatigue. Field-tested tuning of deadband, on-delay, and state-based suppression removes up to 73% of chattering and fleeting alarms. These techniques keep momentary fluctuations or expected process conditions from triggering alerts.
  1. Deadband: Applies hysteresis to analog alarms so they stop toggling around the setpoint. Once an alarm triggers, the process variable must return below setpoint minus the deadband value before the alarm clears.
  2. On-Delay: Adds a time delay before an alarm annunciates. This filters transients like startup spikes or brief sensor glitches, so only persistent abnormal conditions raise alarms.
  3. State-Based Suppression: Temporarily disables or downgrades alarms when the process is in a known state where the alarm condition is expected or irrelevant, so no actionable information is lost.
Nuisance Alarm Technique Recommended Parameter Wastewater Application Example
Deadband 0.5% of span for flow, 1% for pressure, 2% for level A high-level alarm (e.g., 85%) on a clarifier tank clears only when level drops below 83%, preventing rapid on/off toggling near 85%.
On-Delay 5 s for pumps, 15 s for mixers, 30 s for slow-responding processes (e.g., pH) A pump overcurrent alarm activates only if the current remains above the setpoint for 5 seconds, ignoring startup current spikes.
State-Based Suppression Use XOR logic with equipment status bits (e.g., valve position, pump mode) Suppress a 'low flow' alarm on a pump discharge line if the upstream inlet valve is commanded closed (e.g., `IF (INLET_VALVE_CLOSED_BIT XOR ALARM_LOW_FLOW) THEN SUPPRESS_ALARM`).
Systematic application of these parameters cuts alarm noise and lets operators focus on legitimate issues. A PLC-controlled chemical dosing skid, for instance, can integrate these suppression techniques into its level and flow alarms to lift reliability.

Maintain Your Alarm System for <0.5 % Annual Drift

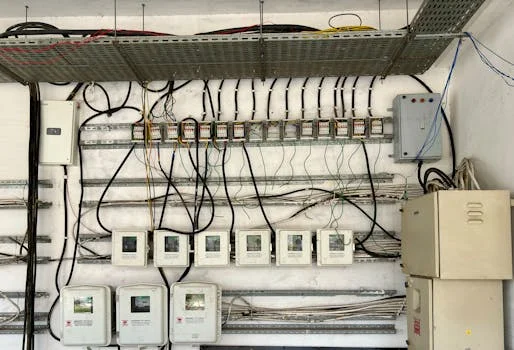

alarm management scada wastewater - Maintain Your Alarm System for &lt;0.5 % Annual Drift
alarm management scada wastewater - Maintain Your Alarm System for &lt;0.5 % Annual Drift
A proactive maintenance schedule prevents performance drift. Without regular review and adjustment, alarm systems slide out of ISA-18.2 compliance, nuisance alarms creep back, and operator effectiveness drops. A 12-month checklist keeps the system tight.
  • Quarterly:
    • Verify all alarm setpoints against current P&ID drawings and process requirements.
    • Recalibrate critical sensors impacting alarm generation (e.g., level, flow, pressure, pH, DO).
    • Export and review ISA KPI reports to spot emerging trends in alarm rates or priority distribution.
  • Semi-annual:
    • Conduct refresher training for operators on the 10 most frequent or highest-priority alarms. Use VR headsets for realistic scenario simulation when available.
    • Review and update alarm descriptions and corrective actions based on operator feedback and process changes.
    • Audit state-based suppression logic so it still aligns with current operational modes and interlocks.
  • Annual:
    • Rerun a full alarm rationalization workshop if ISA KPIs exceed 110% of their target values, indicating significant drift.
    • Perform a comprehensive review of the alarm philosophy document, folding in lessons learned and new process technologies (e.g., a new MBR system with integrated DO control).
    • Evaluate overall alarm-system effectiveness in preventing unplanned downtime and identify further optimization opportunities.
This regimen preserves the alarm system ROI, blocks the gradual creep of nuisance alarms, and keeps operator confidence high. A proactive approach to alarm health pairs well with a strong predictive maintenance roadmap for physical assets.

Who This Is For and Next Step

This playbook fits plant engineers and integrators at municipal or industrial wastewater plants running 10–200 MLD who are losing shifts to nuisance alarms, preparing for an ISA-18.2 audit, or planning a SCADA upgrade. Plants already under 6 alarms/hour with a documented rationalization cycle should look elsewhere—deeper optimization here would be marginal. Send your current alarm KPI snapshot and PLC platform to HydroPure Water for a sizing review and a recommended rationalization scope: request a quote.

Frequently Asked Questions

How many alarms should a 50 MLD plant have?

An ISA-18.2 compliant 50 MLD wastewater plant should target an average of 1 alarm per 150 control tags, giving roughly 100-200 active alarms depending on system complexity. The focus is on actionable, unique alarms, with an annunciation rate held below 6 alarms per hour.

What PLC code reduces alarm floods?

PLC code reduces alarm floods through on-delays, deadbands, and state-based suppression. An on-delay timer blocks transient signals, while a deadband prevents chattering. State-based suppression logic, often using instructions like `IF pump_OFF THEN suppress_low_flow_alarm`, keeps alarms off equipment in an expected state.

How is alarm priority assigned rather than calculated?

Alarm priority is assigned from a predefined matrix, not calculated as a weight. The ISA-18.2 standard uses categories such as Emergency, High, Medium, and Low. Each category is defined by potential consequence (safety, environmental, equipment damage, production loss) and the required operator response time. A common initial ranking method during rationalization is a Severity × Frequency matrix.

What is the typical ROI of an ISA-18.2 alarm rationalization?

An ISA-18.2 rationalization that drives the nuisance rate below 10% and the annunciation rate below 6 alarms/hour typically yields a 38% reduction in unplanned downtime and ROI payback within 11 months. Savings come from avoided discharge fines, fewer emergency callouts, and reduced operator overtime.

How do you measure annual alarm system drift?

Annual drift is measured by comparing current ISA-18.2 KPI values (annunciation rate, nuisance rate, priority distribution, standing alarms) against their target values. Drift above 110% of target on any KPI is the trigger to rerun a full rationalization workshop and refresh the alarm philosophy document.
