Inclined Plate Settler for Food Processing: Engineering Guide with Costs, Compliance & Equipment Checklist 2026

Inclined Plate Settler for Food Processing: Engineering Guide with Costs, Compliance & Equipment Checklist 2026

Inclined plate settlers (lamella clarifiers) remove 92–97% of total suspended solids (TSS) from food processing wastewater, reducing fines and pretreatment costs by up to 30%. With plate spacing of 1–2 inches and surface loading rates of 20–40 m/h, they outperform conventional clarifiers in space-constrained plants. For food applications, they excel at separating fats, oils, and starches—critical for compliance with FDA 21 CFR Part 110 and EU EC 852/2004. This guide provides contaminant-specific performance data, cost benchmarks, and a step-by-step selection checklist for 2025.

Why Food Plants Struggle with Conventional Clarifiers: A Case for Inclined Plate Settlers

Food processing facilities frequently face stringent discharge limits for total suspended solids (TSS) and fats, oils, and grease (FOG), with conventional clarifiers often failing to meet these demands efficiently.

Wastewater from food production contains exceptionally high levels of organic matter, including fats, proteins, and starches. For instance, dairy processing wastewater typically presents TSS concentrations ranging from 500–2,000 mg/L, while meat processing can see levels soar to 1,000–3,000 mg/L, according to USDA 2023 data. These high solids concentrations rapidly overwhelm traditional sedimentation basins, which are designed for lower solids loads and require substantial footprints.

Conventional clarifiers, with their large surface area requirements, demand 3–5 times more physical footprint than modern solutions and typically achieve only 60–80% TSS removal, as indicated by EPA 2024 benchmarks. This inefficiency often leads to costly surcharges or environmental fines for exceeding discharge limits, jeopardizing a plant's operational license and profitability. In contrast, an inclined plate settler for food processing can reduce the required footprint by up to 70% while improving TSS removal efficiency to 92–97% (Parkson Corporation, Top 1 scraped content).

For example, a poultry processing plant in Georgia faced consistent fines totaling $250,000 annually due to elevated TSS and FOG levels in its effluent. After implementing a compact lamella clarifier system, the plant reduced its discharge violations significantly, saving approximately $180,000 per year in fines and surcharges, according to HydropureWater's internal case studies. This demonstrates how advanced HydropureWater’s lamella clarifier for food processing technology directly addresses the operational and compliance challenges inherent in the food industry.

How Inclined Plate Settlers Work: Engineering Principles for Food Processing

Inclined plate settlers operate on the principle of enhanced gravitational settling, significantly increasing the effective settling area within a compact footprint by utilizing a series of closely spaced, inclined plates.

The core innovation of an inclined plate settler design lies in its lamella plates, typically spaced 1–2 inches apart (Hydroflotech, Top 3 page), which is optimally configured for the typically fine and often buoyant particles found in food processing wastewater, ranging from 0.1–1 mm in diameter. Wastewater enters the clarifier and flows upward between these plates, while solids, under the influence of gravity, settle downwards onto the inclined surfaces. The short vertical settling path—only 1–2 inches, compared to 6–12 feet in conventional clarifiers—dramatically reduces the required retention time by up to 80%.

The upflow velocity within the plates, typically maintained at 0.5–1.5 m/h, is crucial for preventing the resuspension of settled solids, particularly lighter organic particles like fats and starches. As solids accumulate on the plates, they slide down the incline due to gravity and coalesce, forming a denser sludge that collects in a hopper at the bottom of the unit. The clarified water, now free of most suspended solids, exits over weirs at the top.

For the lamella clarifier food industry, plate materials are critical for hygiene and longevity. Plates are commonly constructed from food-grade polypropylene or stainless steel, adhering to standards such as FDA 21 CFR 177.1520 for contact with food-related substances. This ensures resistance to corrosive cleaning agents and prevents bacterial growth. In essence, water flows upward between the inclined plates; solids settle onto the plates and slide down into a collection hopper, while clean water overflows at the top.

Contaminant-Specific Performance: What Inclined Plate Settlers Remove in Food Wastewater

inclined plate settler for food processing - Contaminant-Specific Performance: What Inclined Plate Settlers Remove in Food Wastewater
inclined plate settler for food processing - Contaminant-Specific Performance: What Inclined Plate Settlers Remove in Food Wastewater

Inclined plate settlers consistently achieve high removal efficiencies for a wide spectrum of food-specific contaminants, making them an effective pretreatment solution for food processing wastewater.

For general TSS removal in dairy wastewater and other food streams, inclined plate settlers typically achieve 92–97% efficiency (EPA 2024 benchmarks), significantly reducing the load on downstream biological treatment. In terms of FOG, these systems are highly effective: 85–95% removal for dairy fats and 70–80% for meat processing fats (USDA 2023 data). Optimal FOG separation often requires pH adjustment to 6.5–7.5 to break emulsions, followed by chemical coagulation and flocculation. For example, automated coagulant dosing for lamella clarifiers can significantly enhance the aggregation of fine particles and emulsified fats.

Starch removal in potato and vegetable processing can reach 80–90% efficiency. This typically involves optimizing flocculant dosage to encourage starch particles to aggregate and settle. Blood proteins, prevalent in meat and poultry plants, see 60–75% removal when proper flocculation (e.g., using iron salts or polymers) is applied to neutralize charges and promote aggregation. Beyond suspended solids, inclined plate settlers also contribute to a 50–70% reduction in BOD/COD, acting as a crucial wastewater pretreatment for food processing before biological systems.

The following table provides detailed performance benchmarks for common food industry contaminants:

Contaminant Influent Range (mg/L) Removal Efficiency (%) Notes
Total Suspended Solids (TSS) 500–3,000 92–97 General food processing, post-screening
Dairy Fats (FOG) 200–800 85–95 Requires pH 6.5–7.5, chemical pretreatment
Meat Processing Fats (FOG) 300–1,200 70–80 Pre-screening essential, chemical coagulation
Starches (Potato/Veg) 150–600 80–90 Optimal flocculant dosage for aggregation
Blood Proteins 100–400 60–75 Requires charge neutralization (e.g., iron salts)
BOD/COD (as pretreatment) 1,000–5,000 50–70 Overall organic load reduction

Inclined Plate Settler vs. DAF for Food Processing: Head-to-Head Comparison

Choosing between an inclined plate settler and a Dissolved Air Flotation (DAF) system for food processing wastewater hinges on specific contaminant profiles, space availability, and operational cost considerations.

Both technologies are highly effective for removing suspended solids and fats, oils, and grease (FOG). Inclined plate settlers achieve 92–97% TSS removal, while DAF systems typically range from 90–95% (EPA 2024 data). For FOG removal, DAF systems often exhibit a slight edge, achieving 90–98% compared to the 85–95% of lamella clarifiers. This is primarily because DAF excels at separating highly emulsified fats and very fine, buoyant particles by attaching microscopic air bubbles, causing them to float to the surface. However, this often comes at a higher operational cost.

Footprint is a significant differentiator. An inclined plate settler for food processing requires substantially less space, often 70% smaller than a comparable DAF system. For example, a 100 GPM system might require only 50 sq ft for an inclined plate settler, versus 150 sq ft for a DAF system, making lamella clarifiers ideal for space-constrained food plants. Chemical usage also differs; lamella clarifiers can reduce coagulant and flocculant consumption by up to 30% compared to DAF (HydropureWater product catalog), primarily due to their efficient gravitational settling mechanism that requires less chemical assistance to aggregate particles.

Operating costs for inclined plate settlers typically range from $0.05–$0.15 per gallon treated, primarily driven by minimal energy use for pumps and lower chemical consumption. DAF systems, with their air compression and higher chemical requirements, often incur costs of $0.10–$0.25 per gallon. Maintenance for lamella plates involves periodic cleaning (e.g., monthly) to prevent fouling from proteins and starches, while DAF systems require weekly checks of air nozzles and saturation tanks. For a deeper dive into DAF systems, explore our guide on DAF systems in Myanmar.

Here's a head-to-head comparison:

Metric Inclined Plate Settler DAF System Winner
TSS Removal 92–97% 90–95% Inclined Plate Settler
FOG Removal 85–95% 90–98% DAF (especially for emulsified FOG)
Footprint Compact (70% smaller) Larger Inclined Plate Settler
Chemical Use Lower (up to 30% less) Higher Inclined Plate Settler
Operating Cost/Gallon $0.05–$0.15 $0.10–$0.25 Inclined Plate Settler
Maintenance Plate cleaning (monthly) Air nozzle checks (weekly) Tie (different maintenance profiles)

Compliance Checklist: Meeting FDA, USDA, and EU Food Safety Standards with Inclined Plate Settlers

inclined plate settler for food processing - Compliance Checklist: Meeting FDA, USDA, and EU Food Safety Standards with Inclined Plate Settlers
inclined plate settler for food processing - Compliance Checklist: Meeting FDA, USDA, and EU Food Safety Standards with Inclined Plate Settlers

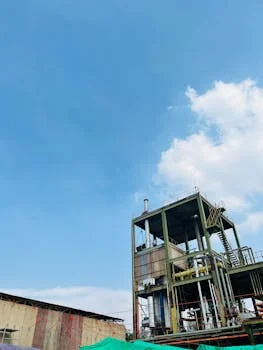

Achieving regulatory compliance for food processing wastewater requires a clear understanding of specific limits and how an inclined plate settler contributes to meeting them.

For operations in the United States, FDA 21 CFR Part 110 mandates general good manufacturing practices, which indirectly necessitate effective wastewater management to prevent contamination. While direct discharge limits vary by locality, many permits require TSS levels below 30 mg/L. An inclined plate settler's 92–97% TSS removal capability is crucial for achieving these low concentrations, often requiring pH adjustment and chemical coagulation as pretreatment. Similarly, USDA FSIS regulations for meat and poultry plants often stipulate FOG concentrations below 100 mg/L in effluent. The high FOG separation equipment efficiency of lamella clarifiers (85–95% for dairy fats, 70–80% for meat fats) makes them indispensable for these sectors.

In the European Union, EC 852/2004 outlines general hygiene requirements for foodstuffs, impacting wastewater quality. Typical EU discharge limits for BOD are below 25 mg/L and COD below 125 mg/L. While inclined plate settlers primarily target solids, their 50–70% BOD/COD reduction as wastewater pretreatment for food processing significantly eases the load on subsequent biological treatment stages, helping plants meet these stringent organic load limits. local discharge limits can be even more restrictive; for example, some California dairy plants must achieve TSS levels below 45 mg/L, requiring robust clarification strategies.

Understanding and integrating these compliance requirements into your wastewater treatment design is crucial. For broader insights into global food processing wastewater solutions, consider exploring our guide on food processing wastewater treatment in Mongolia.

Here is a compliance checklist:

Regulation Key Limit / Requirement How Inclined Plate Settlers Help Notes
FDA 21 CFR 110 (US) Indirectly requires clean facility & discharge 92–97% TSS removal, prevents cross-contamination Supports overall GMPs; local discharge permits dictate direct TSS limits
USDA FSIS (US) FOG & TSS limits for meat/poultry (often FOG < 100 mg/L) 85–95% FOG removal, 92–97% TSS removal Essential for sludge dewatering in meat processing and preventing sewer blockages
EU EC 852/2004 BOD < 25 mg/L, COD < 125 mg/L (common WWT limits) 50–70% BOD/COD reduction as pretreatment Significantly reduces load on biological treatment systems
Local Discharge Permits (e.g., California) TSS < 45 mg/L for dairy; specific pH, FOG, BOD limits Primary clarification to meet specific parameters Requires tailored chemical dosing and monitoring

Cost Breakdown: Inclined Plate Settler Pricing, ROI, and Hidden Costs for Food Plants

The total cost of ownership for an inclined plate settler in food processing extends beyond initial capital outlay, encompassing installation, operational expenses, and potential hidden costs, all contributing to a compelling return on investment.

The capital cost for an inclined plate settler for food processing typically ranges from $20,000 to $150,000 for systems handling 50–500 GPM. This range depends heavily on factors such as construction material (e.g., carbon steel, stainless steel), level of automation, and inclusion of chemical dosing skids. Installation costs, including civil work, piping, and electrical connections, usually fall between $5,000 and $30,000, influenced by the system's footprint and complexity of integration into existing infrastructure. The operational cost, a critical metric for procurement teams, averages $0.05–$0.15 per gallon treated, covering energy consumption for pumps, chemical dosing for lamella clarifiers (coagulants, flocculants), and labor for routine checks and sludge removal.

The Return on Investment (ROI) for an inclined plate settler is often realized within 12–24 months, particularly for plants incurring significant surcharges or fines for non-compliant discharge. For example, a 100 GPM food plant paying $0.20–$0.50 per gallon in fines for high TSS and FOG could save upwards of $80,000 per year by implementing an effective lamella clarifier system. These savings stem from reduced discharge fees, lower hauling costs for dewatered sludge, and avoiding costly regulatory penalties. Beyond direct savings, improved pretreatment can extend the lifespan of downstream biological treatment systems and reduce maintenance on sewer lines.

Hidden costs, though often overlooked, are important for long-term planning. These can include plate replacement, typically needed every 5–10 years at a cost of $1,000–$5,000 per year depending on plate material and wastewater corrosivity. Odor control, especially for meat and dairy processing plants, might require an additional investment of $2,000–$10,000 per year for aeration or chemical dosing systems to prevent anaerobic conditions from fat buildup. Sludge dewatering, for example using plate and frame filter presses, also has associated costs for polymer and disposal.

System Size (GPM) Capital Cost Installation Cost Operating Cost/Gallon ROI (Months)
50 GPM $20,000–$40,000 $5,000–$10,000 $0.10–$0.15 18–30
100 GPM $40,000–$75,000 $10,000–$15,000 $0.08–$0.12 12–24
250 GPM $70,000–$110,000 $15,000–$20,000 $0.06–$0.10 10–18
500 GPM $100,000–$150,000 $20,000–$30,000 $0.05–$0.08 8–15

Troubleshooting Common Issues in Food Processing Applications

inclined plate settler for food processing - Troubleshooting Common Issues in Food Processing Applications
inclined plate settler for food processing - Troubleshooting Common Issues in Food Processing Applications

Operators of inclined plate settlers in the food industry frequently encounter specific challenges related to the unique characteristics of food wastewater, such as protein fouling and odor generation.

One of the most common issues is plate fouling, typically caused by the accumulation of sticky proteins (common in meat and dairy processing) or starchy residues (from vegetable processing). This fouling reduces the effective settling area and diminishes TSS removal efficiency. The diagnostic step involves visual inspection of the plates. The most effective solution is weekly cleaning using a 5% citric acid solution or specialized enzymatic cleaners, applied via spray nozzles or by soaking, followed by a thorough rinse. Another prevalent problem is odor generation, especially in sludge dewatering in meat processing facilities, which often indicates anaerobic conditions due to fat buildup in the sludge hopper. To diagnose, monitor the sludge blanket level and check for hydrogen sulfide (H2S) odors. The fix involves increasing the frequency of sludge removal or introducing diffused aeration into the sludge hopper to maintain aerobic conditions, typically requiring an air flow rate of 0.5–1.0 CFM per 100 gallons of hopper volume.

Poor TSS removal, despite adequate hydraulic loading, often points to issues with chemical pretreatment. Diagnostic steps include performing jar tests to verify coagulant and flocculant dosages, and checking the pH of the influent wastewater. The optimal pH range for most food processing solids separation is 6.5–7.5. Adjusting chemical dosing for lamella clarifiers based on jar test results and maintaining consistent pH are critical. Lastly, sludge buildup in the hopper, leading to blockages or reduced effective volume, is frequently caused by an inadequate hopper slope (less than 55°). Visual inspection of sludge consistency and accumulation rates will confirm this. The solution may involve retrofitting the system with a steeper hopper design or installing vibrators or agitators to prevent bridging and promote consistent sludge discharge. For integrating clarifiers with biological systems, it's beneficial to learn how lamella clarifiers integrate with biological treatment.

Symptom Likely Cause Diagnostic Step Solution
Plate Fouling Protein/Starch accumulation Visual inspection of plates Weekly cleaning with 5% citric acid or enzymatic cleaner
Odor Generation Anaerobic conditions, fat buildup Monitor sludge blanket, check H2S presence Increase sludge removal frequency, add aeration to hopper
Poor TSS Removal Incorrect pH, inadequate chemical dosing Perform jar tests, check influent pH Adjust pH (6.5–7.5 optimal), optimize coagulant/flocculant dosage
Sludge Buildup Inadequate hopper slope (<55°) Visual inspection of hopper, sludge consistency Retrofit steeper hopper, add vibrator/agitator

Frequently Asked Questions

What is an inclined plate settler for food processing?

An inclined plate settler (lamella clarifier) is a high-rate sedimentation device used in food processing to remove suspended solids, fats, oils, and greases from wastewater. It utilizes a series of inclined plates to increase the effective settling area within a compact footprint, achieving 92–97% TSS removal.

How effective are inclined plate settlers for FOG removal in food processing?

Inclined plate settlers are highly effective for FOG removal, typically achieving 85–95% efficiency for dairy fats and 70–80% for meat processing fats. Optimal performance often requires proper pH adjustment and chemical coagulation to break emulsions and aggregate particles.

What are the main advantages of inclined plate settlers over DAF in food plants?

Inclined plate settlers offer a 70% smaller footprint, lower capital and operating costs ($0.05–$0.15/gallon vs. DAF's $0.10–$0.25/gallon), and reduced chemical consumption compared to DAF systems, making them ideal for space-constrained and cost-sensitive food plants.

What are the key compliance standards for food processing wastewater?

Key standards include FDA 21 CFR Part 110 for general hygiene, USDA FSIS for FOG and TSS in meat/poultry (e.g., FOG < 100 mg/L), and EU EC 852/2004 for BOD/COD (e.g., BOD < 25 mg/L). Local discharge permits often set specific TSS, FOG, and pH limits.

What is the typical ROI for an inclined plate settler in a food plant?

The typical ROI for an inclined plate settler in a food plant is 12–24 months. This rapid payback is driven by significant reductions in discharge fines and surcharges, lower sludge hauling costs, and extended lifespan of downstream treatment equipment.

Related Articles

Decanter Centrifuge for Dairy Wastewater: 2026 Guide
Oct 25, 2026

Decanter Centrifuge for Dairy Wastewater: 2026 Guide

Evaluate decanter centrifuges for dairy wastewater sludge, including separation, sizing, energy rec…

Sanitary Screen Cleaning Solutions for Food Processing in 2026
Oct 24, 2026

Sanitary Screen Cleaning Solutions for Food Processing in 2026

Compare sanitary screen cleaning systems for food processing, including CIP, rotary drums, mechanic…

Effluent Treatment Plant in Hawalli, Kuwait (2026 Engineering Guide)
Oct 23, 2026

Effluent Treatment Plant in Hawalli, Kuwait (2026 Engineering Guide)

2026 engineering guide to effluent treatment plants in Hawalli, Kuwait: process selection, design p…

AI Growth
Contact
Contact Us
Call Us
+86-181-0655-2851
Email Us Get a Quote Contact Us
