DAF System in Uzbekistan 2026: Engineering Guide with Costs, Compliance & Local Supplier Checklist

DAF System in Uzbekistan 2026: Engineering Guide with Costs, Compliance & Local Supplier Checklist

A Dissolved Air Flotation (DAF) system is a high-efficiency pretreatment technology for removing suspended solids (TSS), fats, oils, and grease (FOG) from industrial wastewater in Uzbekistan. In 2025, local DAF systems typically handle flow rates from 4 to 300 m³/h, achieving TSS removal rates of 90–98% and FOG removal rates of 95–99% (per Uzbekistan’s State Committee on Ecology and Environmental Protection benchmarks). Key advantages include compact footprint (30–50% smaller than sedimentation tanks), rapid startup (under 30 minutes), and compliance with Uzbekistan’s stringent wastewater discharge limits (e.g., TSS < 30 mg/L, FOG < 10 mg/L). This guide provides Uzbekistan-specific technical specs, cost benchmarks, and a supplier checklist to help engineers and procurement teams select the right DAF system for their application.

Why DAF Systems Are Critical for Uzbekistan’s Industrial Wastewater Treatment

Uzbekistan’s industrial sectors face significant challenges in managing wastewater with high concentrations of fats, oils, and grease (FOG) and suspended solids (TSS), necessitating efficient pretreatment solutions like DAF systems. A textile factory in Tashkent, for instance, recently struggled with effluent containing over 200 mg/L of FOG and high levels of dyes, leading to frequent fines and operational disruptions in its downstream biological treatment plant. Uzbekistan’s top industries generating such challenging wastewater include food processing (especially dairy and meat production), textiles (dyeing and finishing), petrochemicals, and even municipal treatment plants handling mixed industrial discharges (per 2024 State Statistics Committee data).

DAF systems offer a proven solution for these local pain points. For example, a 300 m³/h DAF unit recently shipped to Uzbekistan was instrumental in treating refinery wastewater, reducing influent TSS from 500 mg/L to below 30 mg/L, demonstrating DAF's capability for heavy industrial applications (Order Fulfilled, Top 2 SERP). This performance is critical for meeting Uzbekistan’s strict wastewater discharge limits, which mandate TSS below 30 mg/L, FOG below 10 mg/L, and Chemical Oxygen Demand (COD) below 150 mg/L. Non-compliance can result in substantial penalties, including fines up to 500 times the minimum wage per violation or even facility shutdown, as stipulated by Uzbekistan’s Environmental Code.

Compared to conventional sedimentation tanks, DAF systems present distinct advantages crucial for Uzbekistan’s industrial landscape. DAF units typically require a 30–50% smaller footprint, enabling installation in space-constrained facilities common in urban industrial zones. They also offer approximately 50% faster processing times and can achieve 20–30% lower chemical consumption, particularly beneficial in industries with high FOG loads where sedimentation is ineffective (Xylem refinery case study, Top 3 SERP). These efficiencies make DAF a superior choice for effective wastewater pretreatment in Uzbekistan.

How DAF Systems Work: Technical Mechanisms and Process Parameters

Dissolved Air Flotation (DAF) systems operate through a multi-stage physical-chemical process that effectively separates suspended solids, oils, and greases from wastewater by leveraging the buoyancy of micro-bubbles. The process begins with coagulation, where chemical coagulants (e.g., polyaluminum chloride) are added to neutralize the charge of suspended particles, causing them to clump together. This is followed by flocculation, where polyelectrolytes (flocculants) are introduced to bind these smaller particles into larger, more stable flocs, making them easier to separate. A typical DAF process flow diagram for Uzbekistan would show influent wastewater entering a rapid mix tank for coagulant addition, then moving to a slow mix tank for flocculant addition, before entering the DAF flotation tank.

The core of the DAF process is air dissolution and flotation. A portion of the clarified effluent (10–30% of influent flow) is saturated with air under high pressure (4–6 bar) in a pressure vessel. This supersaturated water is then released into the flotation tank at atmospheric pressure through a pressure-reducing valve, causing billions of microscopic air bubbles (typically 30–50 μm in diameter) to form. These micro-bubbles attach to the pre-conditioned flocs, increasing their buoyancy and causing them to rapidly float to the surface. The optimal air-to-solids ratio for effective flotation generally ranges from 0.02 to 0.06.

Key process parameters are carefully controlled to optimize DAF performance in Uzbekistan's diverse climate. Water temperature, ranging from 10–30°C seasonally, influences floc formation and bubble kinetics. The pH of the wastewater, typically maintained between 6.5–8.5, is critical for coagulant and flocculant efficacy. Influent TSS and FOG ranges, which can vary from 50 mg/L to over 5,000 mg/L depending on the industrial source, dictate chemical dosing and recirculation rates. The final stage is skimming, where a mechanical skimmer blade continuously removes the floated sludge blanket from the surface, while the clarified water exits from the bottom of the tank.

DAF system components include the pressure vessel for air dissolution, an air compressor (often dust-resistant for arid regions in Uzbekistan), the flotation tank, a surface skimmer, and an integrated chemical dosing system for precise chemical addition. Common DAF configurations in Uzbekistan include rectangular tanks, which are versatile for various flow rates, and circular tanks, often preferred for higher flow applications like those found in larger refineries due to their hydraulic efficiency and ease of sludge removal. HydropureWater offers a range of DAF systems for Uzbekistan’s industrial wastewater, designed to meet these diverse needs.

Parameter Typical Range for Uzbekistan Industrial Wastewater Impact on DAF Performance
Influent TSS 50 – 5,000 mg/L Determines chemical dose, sludge volume, and skimmer load.
Influent FOG 10 – 2,000 mg/L Primary target for DAF; influences bubble attachment and sludge consistency.
pH 6.5 – 8.5 Crucial for coagulant and flocculant effectiveness.
Water Temperature 10 – 30°C Affects chemical reaction rates and gas solubility.
Air-to-Solids Ratio 0.02 – 0.06 (kg air/kg solids) Optimal range for effective bubble attachment and flotation.
Recirculation Rate 10 – 30% of Influent Flow Ensures sufficient air saturation and micro-bubble generation.

DAF System Specifications for Uzbekistan: Flow Rates, Removal Efficiencies, and Footprint

daf system in uzbekistan - DAF System Specifications for Uzbekistan: Flow Rates, Removal Efficiencies, and Footprint
daf system in uzbekistan - DAF System Specifications for Uzbekistan: Flow Rates, Removal Efficiencies, and Footprint

DAF systems in Uzbekistan are engineered to accommodate a wide range of industrial wastewater volumes and contaminant loads, with standard capacities typically ranging from 4 m³/h for smaller food processing units to 300 m³/h for large-scale industrial facilities (Order Fulfilled, Top 2 SERP). These systems are designed to deliver consistent and high-performance treatment tailored to the specific effluent characteristics of local industries.

For industrial applications in Uzbekistan, DAF systems consistently achieve high removal efficiencies that meet or exceed local regulatory benchmarks. Typical TSS removal rates range from 90% to 98%, while FOG removal often reaches 95% to 99%. Significant reductions are also observed for Chemical Oxygen Demand (COD) at 70–85% and Biochemical Oxygen Demand (BOD) at 60–80% (per Uzbekistan’s State Committee on Ecology benchmarks). These efficiencies are crucial for allowing facilities to discharge directly or to reduce the load on subsequent biological treatment stages.

One of the primary advantages of DAF technology for Uzbekistan’s often land-constrained industrial facilities is its compact footprint. A DAF system with a capacity of 50 m³/h, for example, typically occupies approximately 12 m² of space, which is significantly smaller compared to a conventional sedimentation tank requiring about 25 m² for the same flow rate. This space efficiency is particularly valuable in urbanized industrial areas or facilities undergoing expansion where land availability is limited.

Energy consumption for DAF systems in Uzbekistan is generally efficient, ranging from 0.1 to 0.3 kWh per cubic meter of treated wastewater. Considering Uzbekistan’s average industrial electricity cost of $0.06/kWh (per 2024 Ministry of Energy data), this translates to manageable operational costs. Chemical dosing remains a critical operational parameter, with typical requirements for coagulants like PAC ranging from 50–200 mg/L, flocculants such as polyacrylamide at 1–5 mg/L, and pH adjusters like NaOH at 0.1–0.5 kg/m³ to optimize treatment performance.

Specification Typical Range for DAF Systems in Uzbekistan Notes/Context for Uzbekistan
Flow Rate Capacity 4 – 300 m³/h Scalable for diverse industrial and municipal needs.
TSS Removal Efficiency 90 – 98% Meets State Committee on Ecology benchmarks.
FOG Removal Efficiency 95 – 99% Critical for food processing, textile, and petrochemical sectors.
COD Removal Efficiency 70 – 85% Contributes to overall effluent quality improvement.
BOD Removal Efficiency 60 – 80% Reduces organic load on downstream biological processes.
Footprint (50 m³/h system) ~12 m² Approximately 50% smaller than conventional sedimentation.
Energy Consumption 0.1 – 0.3 kWh/m³ Cost-effective given local electricity rates ($0.06/kWh).
Chemical Dosing (PAC) 50 – 200 mg/L Varies with influent quality and desired effluent.

DAF vs. Alternative Pretreatment Technologies for Uzbekistan’s Industries

Selecting the optimal wastewater pretreatment technology in Uzbekistan requires a careful comparison of DAF systems against alternatives like lamella clarifiers and conventional sedimentation tanks, considering specific industrial needs and compliance requirements. DAF systems excel in separating FOG and finely suspended solids, making them highly effective for industries with such effluent characteristics. Lamella clarifiers, also known as inclined plate settlers, enhance sedimentation by providing a large settling area in a compact footprint, while traditional sedimentation tanks rely solely on gravity for particle settling.

DAF systems are particularly advantageous in Uzbekistan for industries with high FOG loads, such as food processing (dairy, meat, edible oils), where FOG can rapidly clog conventional clarifiers and interfere with biological treatment. They also perform exceptionally well with variable influent quality, common in textile dyeing and finishing plants, where fluctuating dye concentrations and chemical additives can challenge other systems. DAF's compact footprint makes it ideal for space-constrained facilities, including urban municipal plants that receive industrial discharges. For example, a DAF system can achieve 95%+ FOG removal in textile wastewater, while sedimentation tanks struggle significantly with such loads.

However, DAF may not always be the optimal choice. Alternatives like lamella clarifiers or traditional sedimentation tanks might be more suitable for wastewater with low FOG loads and predominantly inorganic suspended solids, such as in mining wastewater or ceramics production. Similarly, for very large flow rates exceeding 500 m³/h, the capital expenditure for a DAF system might become prohibitive, making large-scale sedimentation basins a more cost-effective option, provided sufficient land is available. For instances where sedimentation is suitable, high-efficiency sedimentation tanks are available.

Hybrid solutions often offer enhanced performance by combining the strengths of different technologies. For example, integrating a DAF system for efficient FOG and TSS removal as a primary step, followed by a lamella clarifier for additional polishing or a Membrane Bioreactor (MBR) system for biological treatment, can achieve superior effluent quality. This approach, like combining DAF for FOG removal with MBR systems for enhanced biological treatment, is increasingly considered in Uzbekistan for meeting stringent discharge standards.

Feature DAF (Dissolved Air Flotation) Lamella Clarifier Sedimentation Tank (Conventional)
Primary Removal Target FOG, TSS, light particles Heavy TSS, settleable solids Settleable TSS
Removal Efficiency (TSS) 90-98% 70-90% 60-80%
Removal Efficiency (FOG) 95-99% Poor (relies on density) Poor (relies on density)
Footprint Compact (30-50% smaller) Compact (enhances settling) Large
Energy Use Moderate (compressor) Low (pumping) Very Low (gravity)
Chemical Consumption Moderate to High (coagulant, flocculant) Low to Moderate (optional coagulant) Low (optional coagulant)
CAPEX Moderate to High Moderate Low to Moderate
OPEX Moderate (energy, chemicals) Low to Moderate Low
Best Use Cases in Uzbekistan High FOG, variable influent, space-constrained facilities (food, textiles, petrochemicals). Moderate TSS, limited space, pre-treatment for biological. Low FOG, high settleable solids, ample land availability.

Cost Breakdown: CAPEX, OPEX, and ROI for DAF Systems in Uzbekistan

daf system in uzbekistan - Cost Breakdown: CAPEX, OPEX, and ROI for DAF Systems in Uzbekistan
daf system in uzbekistan - Cost Breakdown: CAPEX, OPEX, and ROI for DAF Systems in Uzbekistan

The total investment for a DAF system in Uzbekistan involves both capital expenditure (CAPEX) and operational expenditure (OPEX), with a clear return on investment (ROI) often realized through compliance and efficiency gains. The CAPEX for DAF systems in Uzbekistan in 2025 typically ranges from $50,000 to $500,000 USD, largely depending on the system's capacity (from 4 m³/h to 300 m³/h) and the level of customization required for specific industrial applications, as indicated by recent local supplier quotes.

Operational expenditure (OPEX) is primarily driven by energy, chemical consumption, labor, and maintenance. Energy costs are a significant factor, with Uzbekistan’s average industrial electricity cost at $0.06/kWh (per 2024 Ministry of Energy data). Chemical costs, including coagulants, flocculants, and pH adjusters, can range from $0.5 to $2 per cubic meter of treated wastewater, varying with influent quality. Labor typically requires 1–2 operators per shift for monitoring and routine tasks, while annual maintenance costs are estimated at 5–10% of the initial CAPEX, covering spare parts and preventive servicing.

Calculating the Return on Investment (ROI) for a DAF system in Uzbekistan often reveals a compelling economic case, with payback periods typically ranging from 2 to 4 years. For instance, a 50 m³/h DAF system installed in a textile factory, which previously faced monthly fines of $5,000 for exceeding FOG discharge limits (e.g., 200 mg/L influent, >10 mg/L effluent), could achieve compliance by reducing FOG to <10 mg/L. This avoided fine alone, combined with potential reductions in chemical costs for downstream biological treatment, can quickly offset the initial investment. improved effluent quality can reduce surcharges from municipal wastewater authorities.

Financing options for DAF systems in Uzbekistan include various avenues. Leasing solutions, such as those offered by international suppliers like Xylem (Top 1 SERP), provide flexibility. Government grants from initiatives like Uzbekistan’s Green Economy Fund can support environmentally friendly investments. Additionally, some equipment suppliers offer direct financing or deferred payment plans. Prospective buyers should also account for hidden costs such as import duties (typically 15–20% for non-CIS countries), installation expenses (10–20% of CAPEX), and operator training, though some supplier packages include training.

Cost Category Estimated Range (2025 USD) Notes for Uzbekistan
Capital Expenditure (CAPEX)
DAF System Purchase (4-300 m³/h) $50,000 – $500,000 Varies by capacity, materials, and automation level.
Import Duties (if applicable) 15 – 20% of DAF cost For non-CIS country imports.
Installation Costs 10 – 20% of DAF cost Includes civil works, piping, electrical, and commissioning.
Engineering & Design 5 – 10% of DAF cost Site-specific design and integration.
Operational Expenditure (OPEX) per Year (for a 50 m³/h system)
Energy Consumption $7,000 – $20,000 Based on 0.1-0.3 kWh/m³ and $0.06/kWh for 8,000 operating hours/year.
Chemicals (Coagulant, Flocculant, pH adj.) $20,000 – $80,000 Based on $0.5-$2/m³ and 8,000 operating hours/year.
Labor (1-2 operators/shift) $15,000 – $30,000 Uzbekistan average industrial wages.
Maintenance & Spare Parts $2,500 – $25,000 5-10% of CAPEX annually, includes routine parts and servicing.
Return on Investment (ROI)
Typical Payback Period 2 – 4 years Driven by avoided fines, reduced surcharges, and improved downstream process efficiency.

Uzbekistan’s Regulatory Compliance for DAF Systems: Permits, Standards, and Inspections

Ensuring a DAF system meets Uzbekistan’s strict environmental regulations is paramount for industrial operators to avoid significant penalties and maintain operational licenses. The State Committee on Ecology and Environmental Protection sets specific wastewater discharge standards that DAF systems must consistently achieve. Key parameters include TSS below 30 mg/L, FOG below 10 mg/L, COD below 150 mg/L, BOD below 20 mg/L, and a pH range of 6.5–8.5. These limits are among the most stringent in the region, reflecting Uzbekistan’s commitment to environmental protection.

The permitting process for new or upgraded wastewater treatment facilities, including DAF systems, is comprehensive and typically takes 3–6 months. It commences with an Environmental Impact Assessment (EIA), which evaluates the potential environmental effects of the project. Following a positive EIA, approval from the State Ecology Committee is required, leading to the issuance of operational permits. This process often involves detailed technical documentation and demonstrations of the proposed system's capability to meet discharge standards.

Once operational, DAF systems are subject to rigorous inspection requirements. Facilities are mandated to submit quarterly self-monitoring reports, detailing effluent quality data. Annual third-party environmental audits are also typically required to verify compliance. The State Ecology Committee conducts unannounced inspections, and any non-compliance can trigger severe penalties, ranging from fines up to 500 times the minimum wage to temporary or permanent facility shutdown, as per Uzbekistan's Environmental Code. This strict enforcement underscores the importance of reliable DAF performance.

Proper documentation of the DAF system is essential for both permitting and ongoing compliance. This includes a technical passport detailing system specifications, a comprehensive operation manual, and chemical safety data sheets (MSDS/SDS) for all chemicals used in the DAF process. These documents are crucial for permit approval and serve as vital references during inspections and troubleshooting. A notable case study involves a food processing plant in Tashkent that successfully implemented a DAF system, reducing its FOG discharge from an average of 200 mg/L to consistently below 10 mg/L, thereby achieving full compliance with Uzbekistan’s stringent FOG limits and avoiding substantial fines.

Supplier Checklist: How to Evaluate DAF System Vendors in Uzbekistan

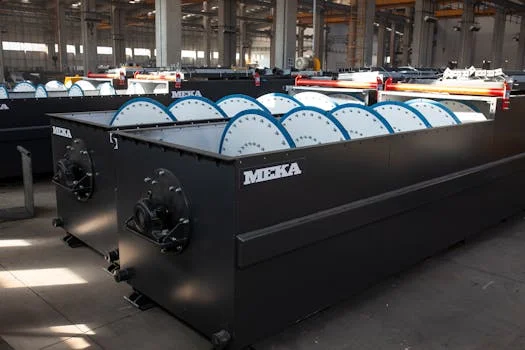

daf system in uzbekistan - Supplier Checklist: How to Evaluate DAF System Vendors in Uzbekistan
daf system in uzbekistan - Supplier Checklist: How to Evaluate DAF System Vendors in Uzbekistan

Evaluating DAF system vendors in Uzbekistan requires a systematic approach that balances technical performance with local support capabilities and commercial terms. Industrial engineers and procurement teams must consider both local and international suppliers, each presenting distinct advantages and disadvantages. Local suppliers, for instance, typically offer faster service response times and a better understanding of local regulations, but may sometimes lack the advanced features or extensive R&D of international firms. Conversely, international suppliers often provide higher efficiency systems and cutting-edge technology but may have longer lead times for spare parts and require a local service partner.

Technical evaluation criteria are paramount in selecting a DAF system. Procurement teams should demand clear guarantees on removal efficiency for TSS, FOG, COD, and BOD, tailored to their specific wastewater characteristics. Critical attention must be paid to energy consumption figures (kWh/m³) and chemical dosing requirements (mg/L or kg/m³), as these directly impact operational costs. The system's footprint is also a key consideration, especially for facilities with limited space. Requesting detailed technical specifications and performance data for various dissolved air flotation DAF systems is essential.

Commercial evaluation criteria extend beyond the initial capital expenditure (CAPEX). Prospective buyers should scrutinize the operational expenditure (OPEX) estimates provided by vendors, including anticipated costs for energy, chemicals, and labor. The warranty period, typically 1–3 years, and the scope of after-sales support are crucial. This includes the availability of spare parts in Uzbekistan, technical support hotlines, and comprehensive operator training programs. A robust after-sales service network in Tashkent or Samarkand can significantly reduce downtime and operational headaches.

A site visit checklist should be employed to verify supplier claims. Requesting references from Uzbekistan-based clients and, if possible, visiting operational DAF systems installed by the vendor can provide invaluable insights into real-world performance and reliability. Verifying supplier certifications, such as ISO 9001 for quality management and CE marking for European safety standards, ensures adherence to international best practices. Red flags that should prompt caution include suppliers without established Uzbekistan-based service teams, vague performance guarantees that lack specific numerical targets, or a complete absence of local case studies demonstrating successful installations.

Category Evaluation Criteria Uzbekistan-Specific Considerations
Technical Performance Guaranteed Removal Efficiencies (TSS, FOG, COD, BOD) Must meet Uzbekistan's State Committee on Ecology benchmarks.
Energy Consumption (kWh/m³) Compare against local industrial electricity costs ($0.06/kWh).
Chemical Dosing Requirements (mg/L, kg/m³) Impacts OPEX; consider local chemical availability and cost.
System Footprint & Layout Critical for space-constrained facilities in industrial zones.
Commercial & Support Total Cost (CAPEX + OPEX over 5 years) Include import duties, installation, and ongoing costs.
Warranty & After-Sales Support Minimum 1-3 years warranty; local service team, spare parts availability.
Operator Training & Documentation Availability of manuals in Uzbek/Russian, on-site training.
Vendor Credibility Uzbekistan-based References & Case Studies Verify successful installations and client satisfaction locally.
Certifications (ISO 9001, CE, etc.) Ensures quality manufacturing and safety standards.
Local Service & Engineering Team Crucial for rapid response and technical assistance in Uzbekistan.

Maintenance and Troubleshooting for DAF Systems in Uzbekistan’s Climate

Effective maintenance is crucial for ensuring the long-term performance and reliability of DAF systems, especially in Uzbekistan’s arid climate with its specific environmental challenges. Implementing a robust preventive maintenance schedule can prevent common issues and extend the lifespan of critical components. Daily checks should include monitoring pH and flow rates, while weekly tasks involve inspecting the skimmer blades and oiling moving parts. Monthly maintenance typically focuses on the air compressor, including filter cleaning and oil changes, and quarterly tasks should involve thorough tank cleaning to prevent sludge buildup and ensure optimal flotation.

Uzbekistan’s climate presents unique challenges for DAF system operation. High dust levels, particularly during dry seasons, can clog air compressor filters, reducing efficiency and potentially damaging the compressor if not regularly maintained. Temperature fluctuations, which can be significant between day and night or seasonally, affect chemical dosing effectiveness; operators may need to adjust coagulant and flocculant concentrations based on water temperature to maintain optimal floc formation. Power instability, common in some industrial areas, necessitates robust surge protection for electrical components and consideration of backup power systems to prevent disruptions.

Troubleshooting common DAF issues requires a systematic approach. If poor flotation is observed, a common cause is a low air-to-solids ratio, which can be remedied by adjusting the recirculation rate or checking the air compressor's performance. Excessive foaming might indicate an imbalance in chemical dosing or the presence of surfactants in the influent, requiring chemical adjustments or defoamer addition. For issues with sludge removal, checking skimmer blade alignment and motor function is essential. Comprehensive training on these troubleshooting steps is vital for local operators.

Maintaining an adequate spare parts inventory is critical to minimize downtime. Essential components such as air compressor filters, skimmer blades, pressure gauges, and chemical dosing pumps should be readily available. Establishing relationships with local suppliers in major industrial hubs like Tashkent and Samarkand for these critical parts can significantly reduce lead times. Operator training requirements include certification from bodies like Uzbekistan’s State Technical Supervision Agency, adherence to safety protocols for chemical handling, and comprehensive emergency shutdown procedures. Integrating a reliable PLC-controlled chemical dosing system for DAF systems in Uzbekistan can further optimize chemical usage and reduce operator intervention.

Frequently Asked Questions

What is the typical payback period for a DAF system in Uzbekistan?
The typical payback period for a DAF system in Uzbekistan ranges from 2 to 4 years, depending on the specific industry, flow rate, and the economic benefits derived from avoided fines and reduced chemical costs.

Can DAF systems handle Uzbekistan’s high dust levels?
Yes, DAF systems can effectively operate in Uzbekistan’s dusty climate, provided they are equipped with dust-resistant air compressors and undergo regular maintenance, including frequent filter cleaning and inspections.

What are Uzbekistan’s wastewater discharge limits for DAF-treated effluent?
Uzbekistan’s wastewater discharge limits for DAF-treated effluent are stringent: TSS < 30 mg/L, FOG < 10 mg/L, COD < 150 mg/L, and a pH range of 6.5–8.5, as per the State Committee on Ecology and Environmental Protection.

How does DAF compare to sedimentation tanks for textile wastewater in Uzbekistan?
For textile wastewater in Uzbekistan, DAF systems are significantly more effective than sedimentation tanks, typically requiring a 30–50% smaller footprint and achieving over 95% FOG removal, whereas sedimentation tanks struggle with the high FOG and fine suspended solids characteristic of textile effluent.

Are there local suppliers for DAF systems in Uzbekistan?
Yes, there are local suppliers for DAF systems in Uzbekistan, including HydropureWater, and international suppliers like Xylem often have local service teams or partners to support installations and maintenance in the region.

Further Reading

Related Articles

Ammonia Wastewater Treatment MBR Design Parameters: 2026 Guide
Jun 19, 2026

Ammonia Wastewater Treatment MBR Design Parameters: 2026 Guide

Ammonia wastewater treatment by MBR pairs submerged 0.1 μm PVDF membranes with nitrifying biomass a…

Ammonia Contact Oxidation for Wastewater: 98% NH3-N Removal Specs
Jun 19, 2026

Ammonia Contact Oxidation for Wastewater: 98% NH3-N Removal Specs

Biological ammonia contact oxidation reaches 98% NH3-N removal at 20–24 h HRT and DO above 2 mg/L, …

IPA Wastewater Treatment by Contact Oxidation: 2026 Engineering Specs, 95%+ COD Removal & Zero-Fouling Reactor Design
Jun 19, 2026

IPA Wastewater Treatment by Contact Oxidation: 2026 Engineering Specs, 95%+ COD Removal & Zero-Fouling Reactor Design

Discover 2026 engineering specs for IPA wastewater treatment using biological contact oxidation—ach…

AI Growth
Contact
Contact Us
Call Us
+86-181-0655-2851
Email Us Get a Quote Contact Us
